This early gas sale commencing at 1 MMSCFD represents the initial and gradual progress of gas production and this initial gas production is part of Tanjung Enim development phase that will increase to a total peak production of 25 MMSCFD as approved under the Tanjung Enim POD-1.

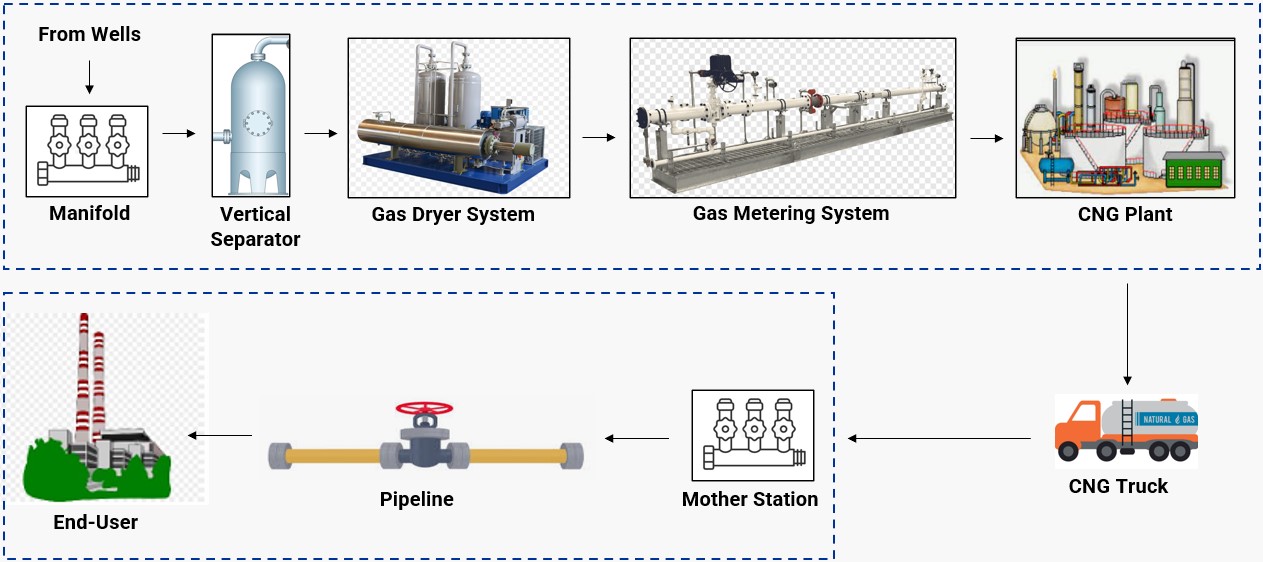

The gas from wells will be collected into a manifold, then come to the separator and the dryer system to achieve the gas sales specification.

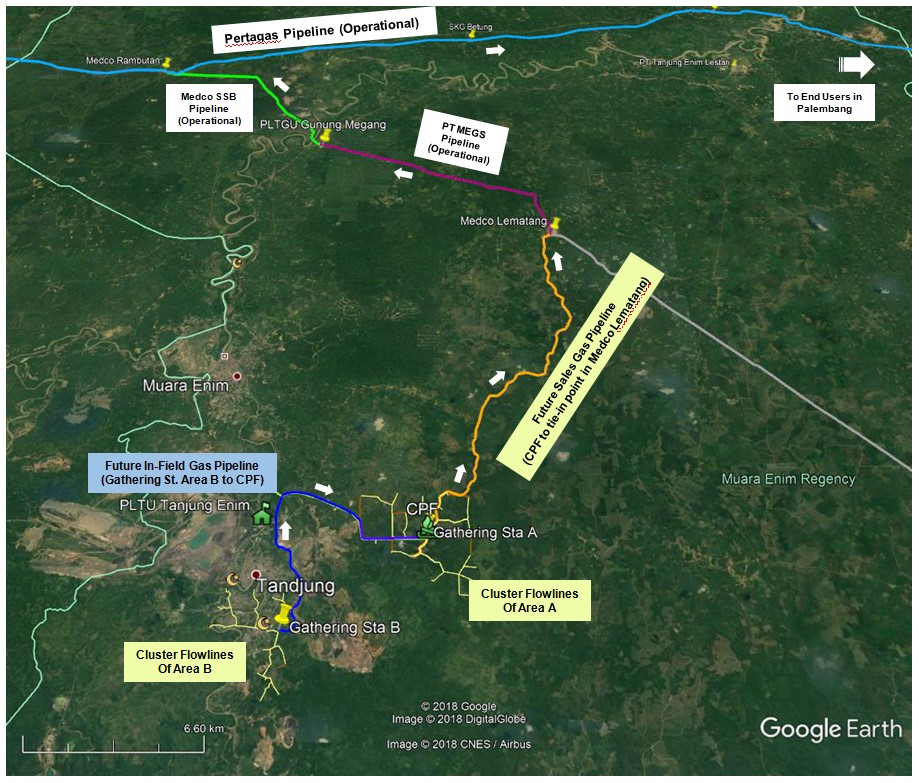

In the Full Development of the Tanjung Enim POD-1 is estimated to produce around 25 MMSCFD from Area A and Area B with 209 wells to be drilled throughout the POD Period.

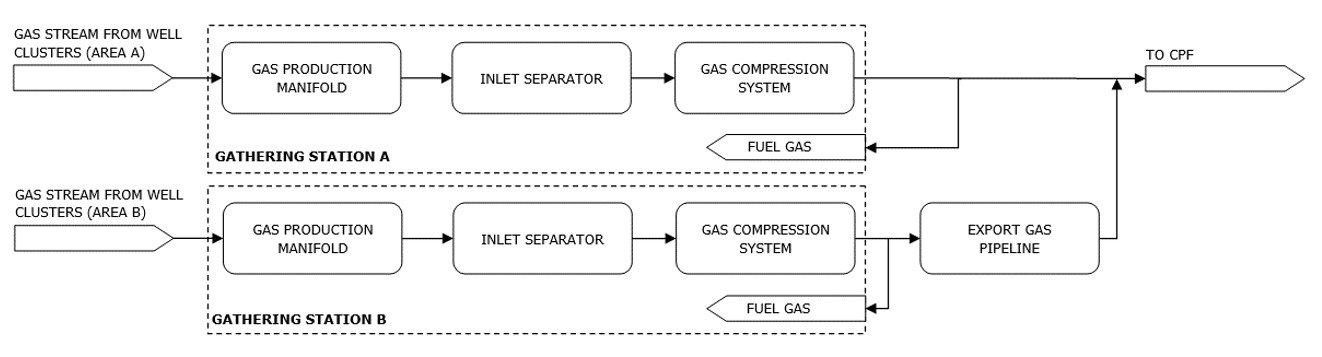

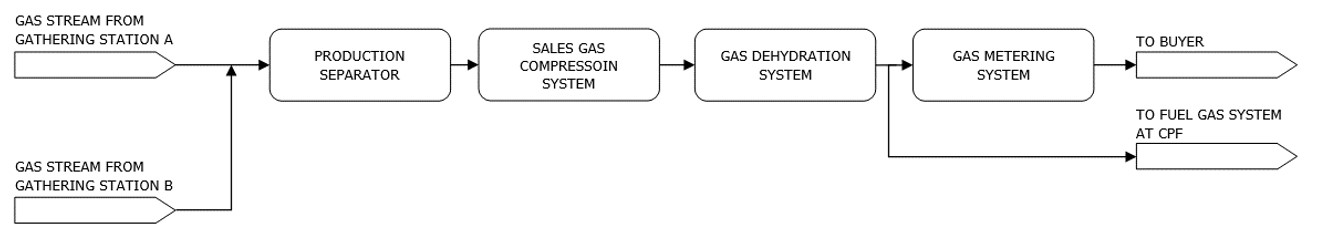

The gas produced from area A and area B will be collected at each Gathering Station A and B. where it will be separated from carried liquid and compressed prior to entering Central Production Facilities (CPF).
